Recladding a Leaky Home in Auckland: A Homeowner's Roadmap
featuring Superior Renovations
- 199.6K profile views
- 115 saves
From the first musty smell to the Code Compliance Certificate: the seven stages of recladding a leaky Auckland home, and the document each one should leave you holding.
Stage 1: Read the symptoms against the year your house was built
The first sign is rarely dramatic. A skirting board that has gone soft in the corner of a bedroom. A musty smell that comes back every winter. A hairline crack in the plaster under a window that you painted over two summers ago.
If your house was built in the 1990s or early 2000s, those small things are how leaky homes in NZ usually announce themselves. Spotting them is the easy part. Working out what to do first is harder.
House recladding is a sequence, not a single decision, and the order you do things in decides how much certainty you have when the money is committed. This roadmap follows that sequence from the owner's side: what each stage involves, what document it should leave you holding, and which choices are only cheap at one particular moment. For the build itself, the Superior Renovations recladding team runs assessment, consent, framing repair and the new cladding under one contract. For current prices by house type, our Auckland recladding cost guide has the full breakdown. This article is about the steps that come before, around and after those numbers.
A damp smell in a 1920s villa with no underfloor ventilation is a different problem from the same smell in a 2001 plaster home. Put what you're seeing next to your build year before you decide how worried to be.
Auckland Council's guidance is that weathertightness problems generally relate to properties built from the early 1990s, regardless of cladding type. Monolithic cladding gets most of the attention, but the Council lists design, location, workmanship and detailing as factors too. So a weatherboard house from 1999 isn't automatically in the clear, and a plaster house isn't automatically leaking.
The signs worth writing down
Walk the house on a wet week and note where you find any of these:
- Musty smells, especially in rooms with an exterior wall
- Soft, bulging or sagging wall and ceiling linings
- Stained or rotting skirting boards and carpet edges
- Black mould spots near windows or where walls meet
- Cracks in exterior plaster, particularly around windows and where one storey meets the next
- Paint that peels or blisters in patches on the outside walls
The design features that carry more risk
Some parts of a house take on water more readily than others. Decks built over living areas, windows and penetrations without proper flashings, flat roofs, roof-to-wall junctions and handrail fixings that go through the cladding are all commonly associated with weathertightness problems. Having one of these doesn't mean you have a leaky home. Having several, on a house from the risk years, is a good reason to move to Stage 2 rather than wait.
If you're still working out whether your plaster is the old direct-fixed kind, our explainer on what makes a direct-fixed plaster home higher risk covers how to tell and why the cavity behind the cladding matters so much.
What you should have at the end of Stage 1: a dated list of symptoms, a few phone photos of each, and your build year.
Stage 2: Get an independent moisture assessment before you ask for a quote
This is the step owners most often skip, and it's the one that makes every later number more honest. A reclad quote written without knowing what's behind the cladding is an estimate wearing a quote's clothes.
A weathertightness surveyor drills small holes through the wall linings and takes moisture readings at the places water is most likely to get in. It doesn't show you every stud, but it gives a map of where the framing is wet and roughly how far it has spread. Our cost guide puts a thorough Auckland inspection at $1,000 to $2,500.
Why "independent" matters
The report should answer one question: what's happening inside these walls? It's easier to trust when the person writing it isn't also pricing the fix. Give the same report to every builder, so they all scope the same house.
Buying rather than owning?
Auckland Council notes that pre-purchase inspection standards require inspectors to report weathertightness risk. On a house from the risk years, add a specialist moisture survey and order the Council property file, which shows the consent history and any past remedial work.
What you should have at the end of Stage 2: a written moisture report with a marked-up plan of where readings were taken and what they showed.
Stage 3: Decide the scope – targeted repair or full reclad
Not every leak ends in a full reclad. The moisture report decides which job you're looking at, not a price list.
When a targeted repair can work
A targeted repair makes sense when the moisture traces back to one detail and the rest of the envelope is dry. A single window head flashing, a deck-to-wall junction or a balustrade fixing are the usual examples. The cladding comes off around the failure, the framing is checked and repaired, the detail is rebuilt properly and the cladding is made good.
When the whole wall system is the problem
On a direct-fixed plaster home with no drainage cavity, the issue is usually the system rather than one window. Three things tip it towards a full reclad:
- No cavity behind the cladding. Water that gets past the surface has nowhere to drain or dry.
- Signs on more than one elevation. Cracking, staining or soft spots on several faces point to a failure across the house, not a local one.
- Untreated framing. Some homes from the late 1990s and early 2000s have untreated timber behind the cladding, which turns a small leak into structural repair.
On that kind of house, a run of separate targeted repairs can end up costing more than one properly scoped reclad, and you live through the disruption several times instead of once. There's a resale angle too. A patched plaster home is still a plaster home to a buyer's building inspector and to an insurer.
The upgrade decisions that belong here
Scope is also where you decide what else to do while the walls are open. Two items are far cheaper now than later:
- Window joinery. Replacing windows during a reclad runs about $800 to $1,500 each on our figures. Doing it later as a separate job is closer to $1,200 to $2,000 each, because the flashings get done twice.
- Wall insulation. With the cladding off, the wall cavity is open. It's the easiest moment the house will ever give you to add or upgrade wall insulation.
What you should have at the end of Stage 3: a written scope that says repair or reclad, which elevations, and whether windows and wall insulation are in or out.
Stage 4: Design and building consent
Most of the paperwork happens here, and so does most of the waiting before anything visible starts on site.
A reclad needs a design: the new cladding system, a cavity, flashing details at every window and door, and the junctions at decks, roofs and balustrades. Where the reclad changes the look of the house, restructures windows or crosses into an extension, our sister practice Sonder Architecture handles the consent-stage design. Their guide to how the E2 external moisture clause shapes a cladding design is a clear read if you want to know what the designer is working to.
Consent is a question for the Council, not a guess
Recladding works directly on the part of the house that keeps water out, which is why it usually goes through building consent. Whether your job needs consent, and whether it counts as Restricted Building Work that a Licensed Building Practitioner must carry out or supervise, depends on your house and your scope. Ask Auckland Council or an LBP before any cladding comes off, not after. Our guide to when a reclad needs building consent explains the exemptions people ask about and why they're narrower than most expect.
If you live in parts of Devonport, Ponsonby or Grey Lynn, check the property file for character or heritage protections as well. A reclad in those areas can need resource consent on top of building consent, with a material and profile that suits the overlay.
The homes where we find the worst hidden damage are almost always the ones where someone did a patch job without consent, they covered the problem up rather than fixing it. Consent inspections aren't red tape. They're the thing that catches rot before you seal a new cladding system over the top of it.
— Dorothy Li, Design Manager, Superior Renovations
On our current figures, a standard Auckland reclad consent costs $5,000 to $7,000, and a complete, well-documented application usually gets a decision within four to eight weeks. Incomplete paperwork is what slows it down, because each request for more information restarts the clock.
What you should have at the end of Stage 4: consented drawings and specifications, and the consent itself with its list of required inspections.
Stage 5: Plan the money and the months
With the scope written and consent close, the rough budget can become a real one.
The ranges to start from
Superior Renovations' published figures put a standard two-storey Auckland reclad at $330,000 to $380,000 (excl. GST), with single-storey homes from $135,000 and complex leaky homes at $500,000 or more. Scaffolding alone is typically $10,000 to $20,000, and on a sloping or tight section it can be one of the biggest single lines in the quote. To see where your own house might land, put its size and cladding type into our house reclad calculator and compare the result with your written scope.
Ask how the framing allowance works
Nobody can see the framing until the cladding is off, so every honest reclad price carries an allowance for it. On 1994 to 2004 plaster homes we budget a framing replacement allowance of 15 to 25% in the fixed-price contract, because it's rarely zero on those builds. The question to ask every builder is what happens if the framing turns out better or worse than the allowance. With us, a better result is credited back and a worse one becomes a documented variation you see and sign before work continues.
Where will you live?
A reclad is loud, dusty and, for stretches, leaves rooms with no outside wall. Moving out for the heaviest weeks is often the sensible call. Our figure for temporary accommodation in Auckland is $400 to $800 a week, and a standard full reclad typically runs six to 14 weeks on site. Budget for the weeks you actually need to be out, not the whole programme.
What you should have at the end of Stage 5: a signed contract with the framing allowance written into it, a programme, and a plan for where you'll be living.
Stage 6: What happens once the cladding comes off
The build starts with protection: a temporary weatherproof wrap outside, covered floors and joinery inside, and power, water and access sorted before anything is stripped. Then the old cladding comes off, one elevation at a time. If testing has found asbestos in the existing cladding, a licensed removalist deals with it before the main work carries on.

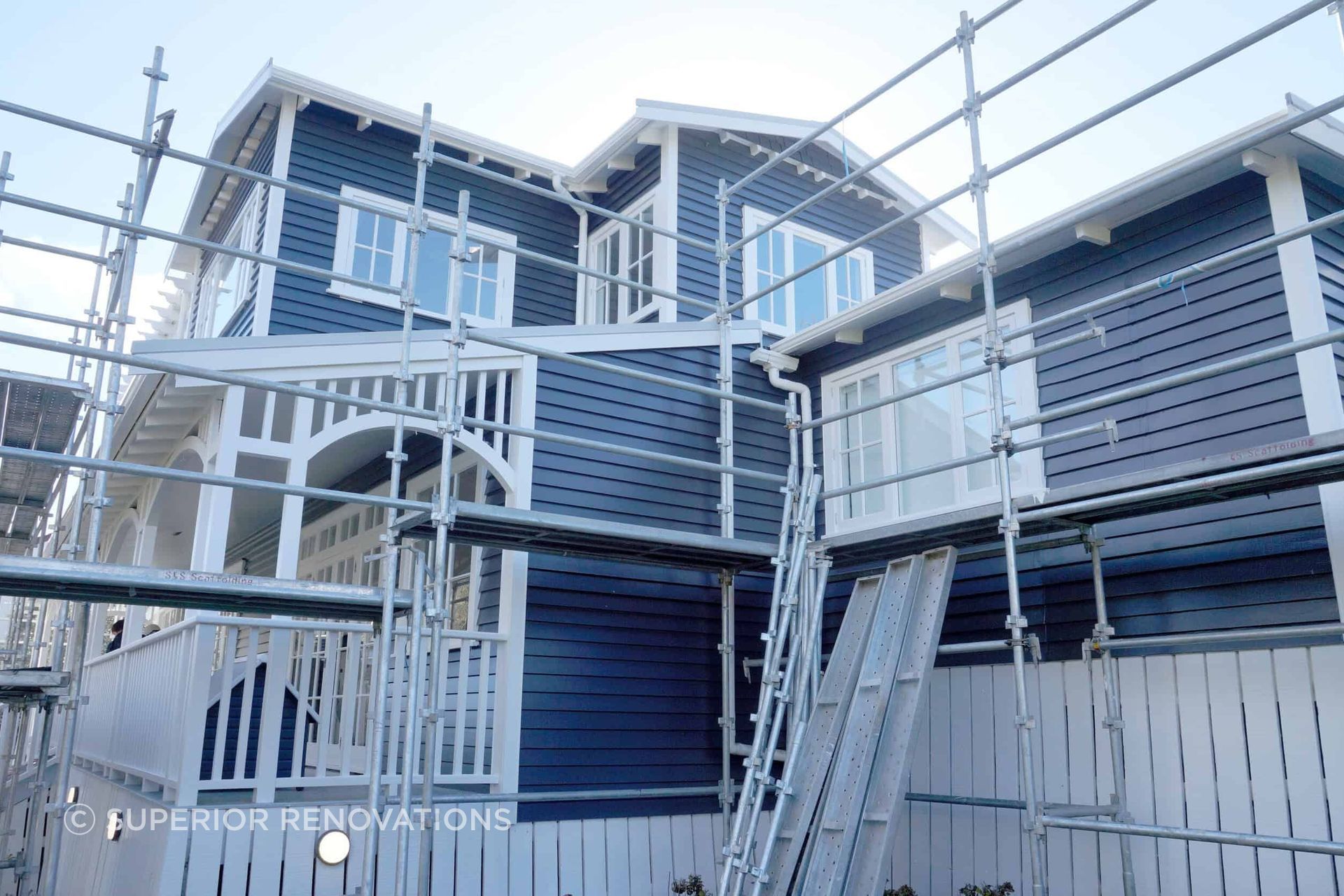

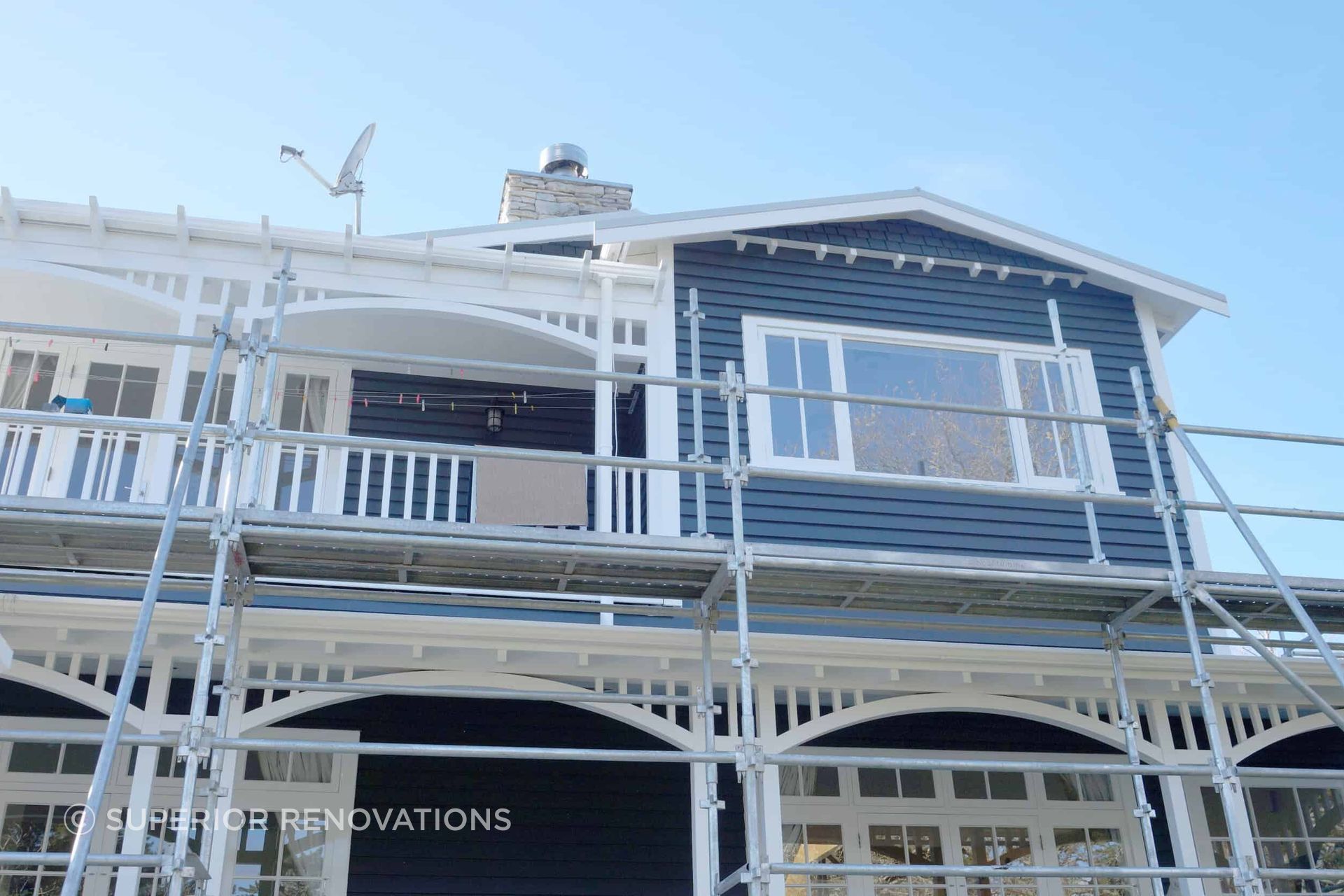

The two photos below come from the recladding work on our own recladding page: a two-storey weatherboard villa late in the build, with the new boards and white trim in place and the scaffold still up. The first shows the rear corner and upper storey (left). The second shows the front verandah and gable (right).
The framing inspection is where the final cost is set
With the framing exposed, an independent building consultant or an LBP inspects every member, records what's decayed and writes the scope of remedial framing work. This is the stage where the allowance you signed for is either confirmed or turned into a variation, and it's the point to ask for photos of anything that's being replaced. Keep those photos. They're part of the house's history from now on.
Repair, reclad, reinstate
Damaged framing is replaced with treated timber to the current Building Code. Then the new wrap, cavity battens, flashings and cladding go on, windows are reflashed or replaced, and gutters, downpipes and any deck on the cladding line are reinstated. The Council inspects at the stages set out in your consent.
What you should have at the end of Stage 6: photos of the exposed framing, any signed variations, and a record of each Council inspection passed.
Stage 7: Code Compliance and the file you keep
The job isn't finished when the scaffold comes down. After the final inspection, the Council issues the Code Compliance Certificate, and that certificate is what a future buyer, their lawyer and your insurer will ask to see.
Build a reclad folder
Keep these together, on paper and digitally:
- The original moisture report
- Consented drawings and specifications
- Framing inspection records and photos
- Signed variations
- The Code Compliance Certificate
- Product warranties and the maintenance schedule for the new cladding
A reclad to a cavity-backed system changes how the house is seen by buyers and insurers, but only if you can prove what was done. The folder is that proof.
Maintenance keeps the reclad working
Auckland's old weathertightness failures kept coming back to small junctions: window heads, roof lines, ground-level flashings. Wash the house, check flashings and sealant joints, keep the cavity vents clear and repaint on your product's schedule. North and west walls weather faster than south. On the North Shore coast or in the eastern bays, salt air makes the regular wash matter more.
Frequently asked questions
What are leaky homes in NZ?
A leaky home is one where water has been getting into the wall structure and can't get out, so the timber framing slowly rots. Auckland Council links weathertightness problems mainly to homes built from the early 1990s, across cladding types, with design, location, workmanship and detailing all playing a part. Monolithic plaster without a cavity is the best-known case.
Do I have to reclad the whole house?
Not always. If an independent moisture report traces the problem to one detail and the rest of the walls are dry, a targeted repair can be the right answer. If there's no cavity, signs show on several elevations, or the framing is untreated, a full reclad is usually more reliable and often cheaper than a series of separate repairs.
Can I still make a weathertight homes claim?
Not through the Weathertight Homes Resolution Service. Under the Weathertight Homes Resolution Services Act 2006, the last date to bring a claim was 31 December 2021. If your house has an earlier claim on record, it'll show in the Council property file. For any other legal options, talk to a lawyer with weathertightness experience.
How much does it cost to reclad a house in Auckland?
On Superior Renovations' published figures, a standard two-storey reclad is $330,000 to $380,000 (excl. GST), single-storey homes start from $135,000, and complex leaky homes reach $500,000 or more. Framing condition is the biggest variable, which is why a moisture assessment before quoting gives you a far more reliable number.
Recladding a leaky home is a big job, but it's a manageable one when each stage leaves you holding the right piece of paper before you move to the next.
Bring your symptom list and moisture report to our showroom at 16B Link Drive, Wairau Valley, or book a free consultation and bring your moisture report with you. You'll find more on how we work at superiorrenovations.co.nz.
