The Construction Journey for Fitzroy Ltd:

Balmain & Co were awarded the construction of Fitzroy Ltd in 2019.
Located a short walk down Gore Street from the Lyric, Fitzroy Ltd is the perfect mix of raw authenticity and an understated elegance combined with an emphasis on city views, light, space and materiality. Consisting of 82 high-end apartments, Fitzroy Ltd sits at 7-levels above ground and features a breath-taking internal courtyard, rooftop garden and a beautifully crafted entrance lobby.
Balmain & Co will be undertaking the early works for this project which involves demolition, excavation, ground preparation, piling, shotcrete, capping beam and basement slabs.

Construction Update: October 2019

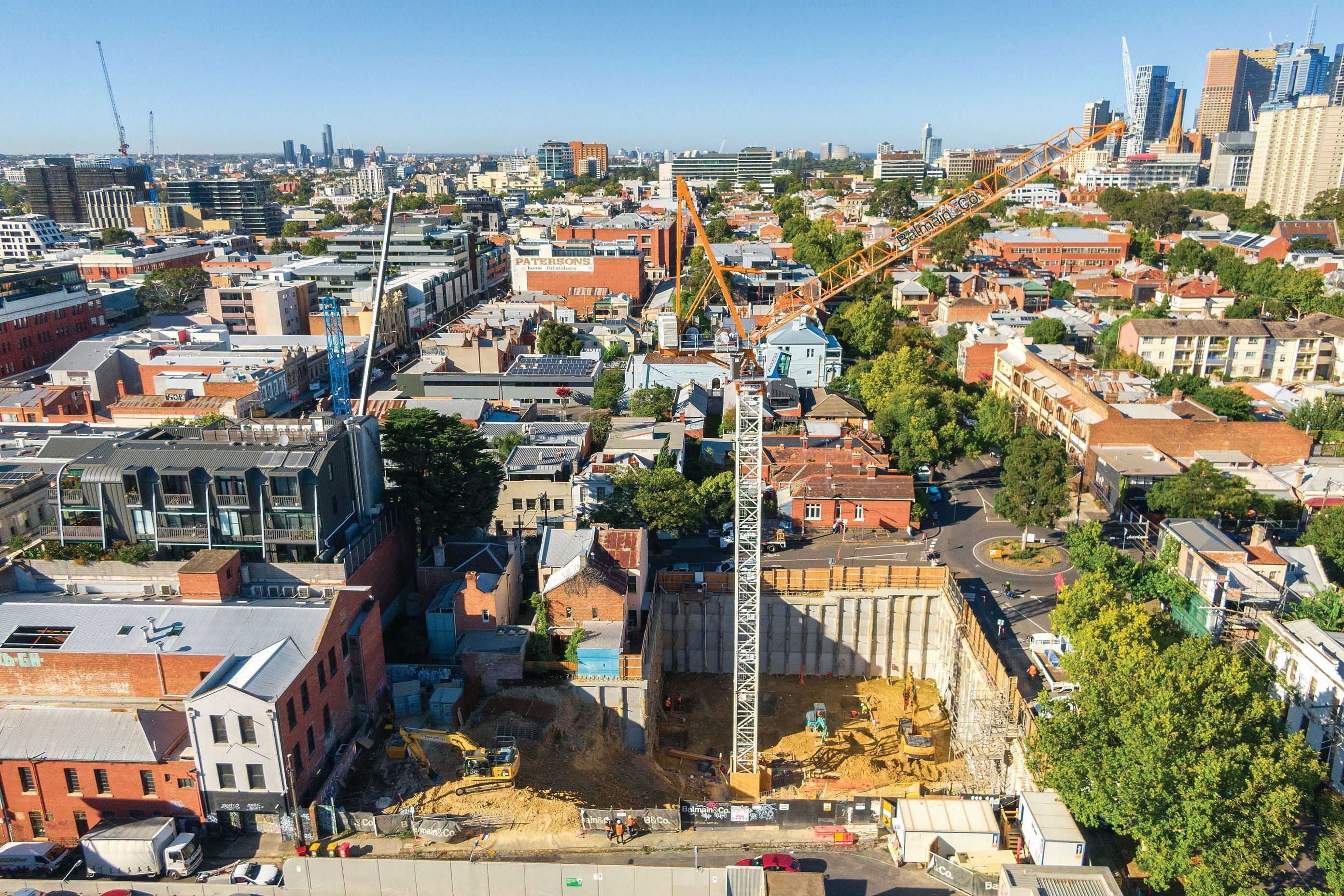

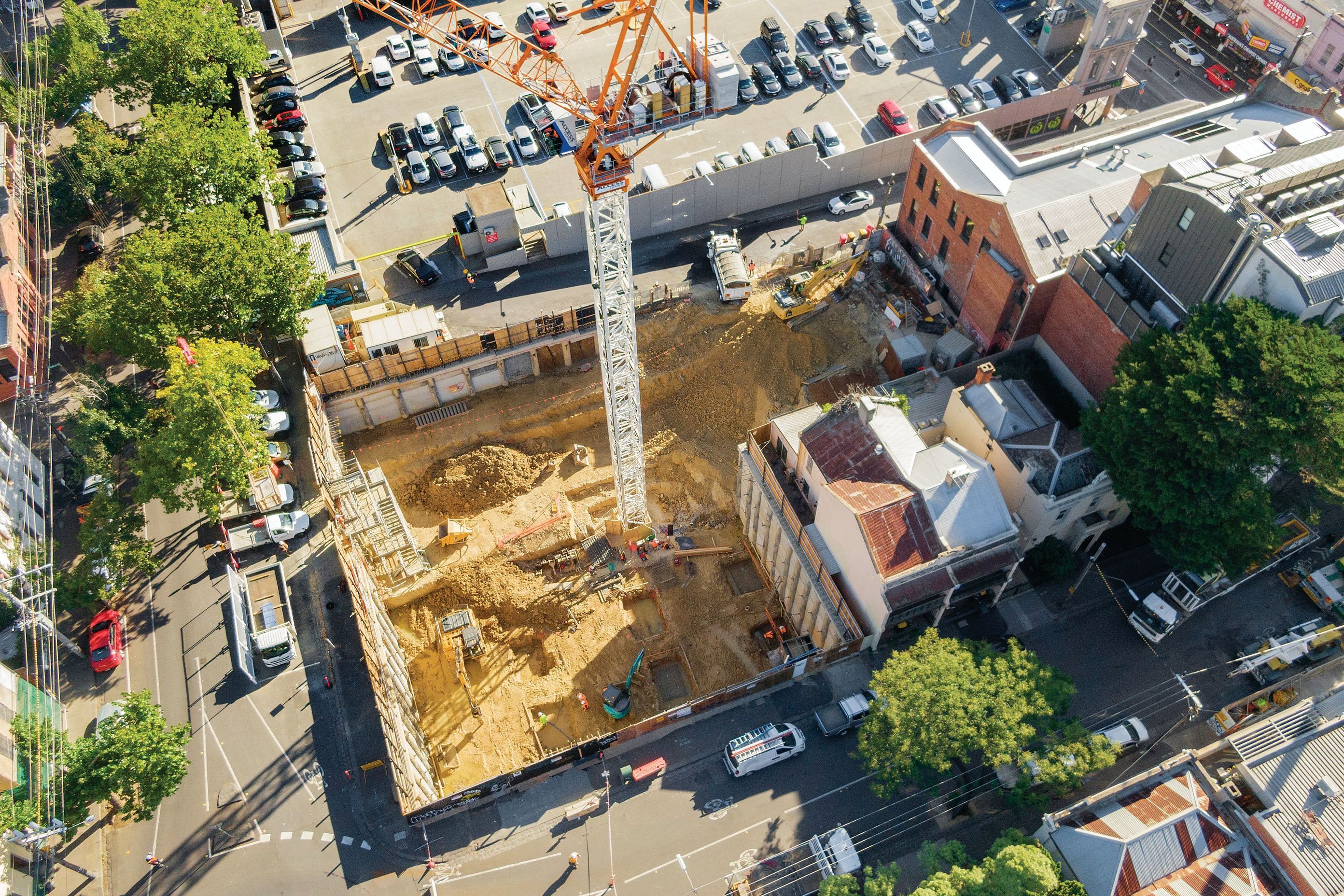

Demolition has already wrapped up on site and basement works have since commenced at Fitzroy Ltd. Trucks have been running in and out this week in preparation for the piling rig due on site in the coming weeks. Next month will see piling, capping beam, bulk excavation, shotcrete and ground anchors as we make our way down to the bottom.

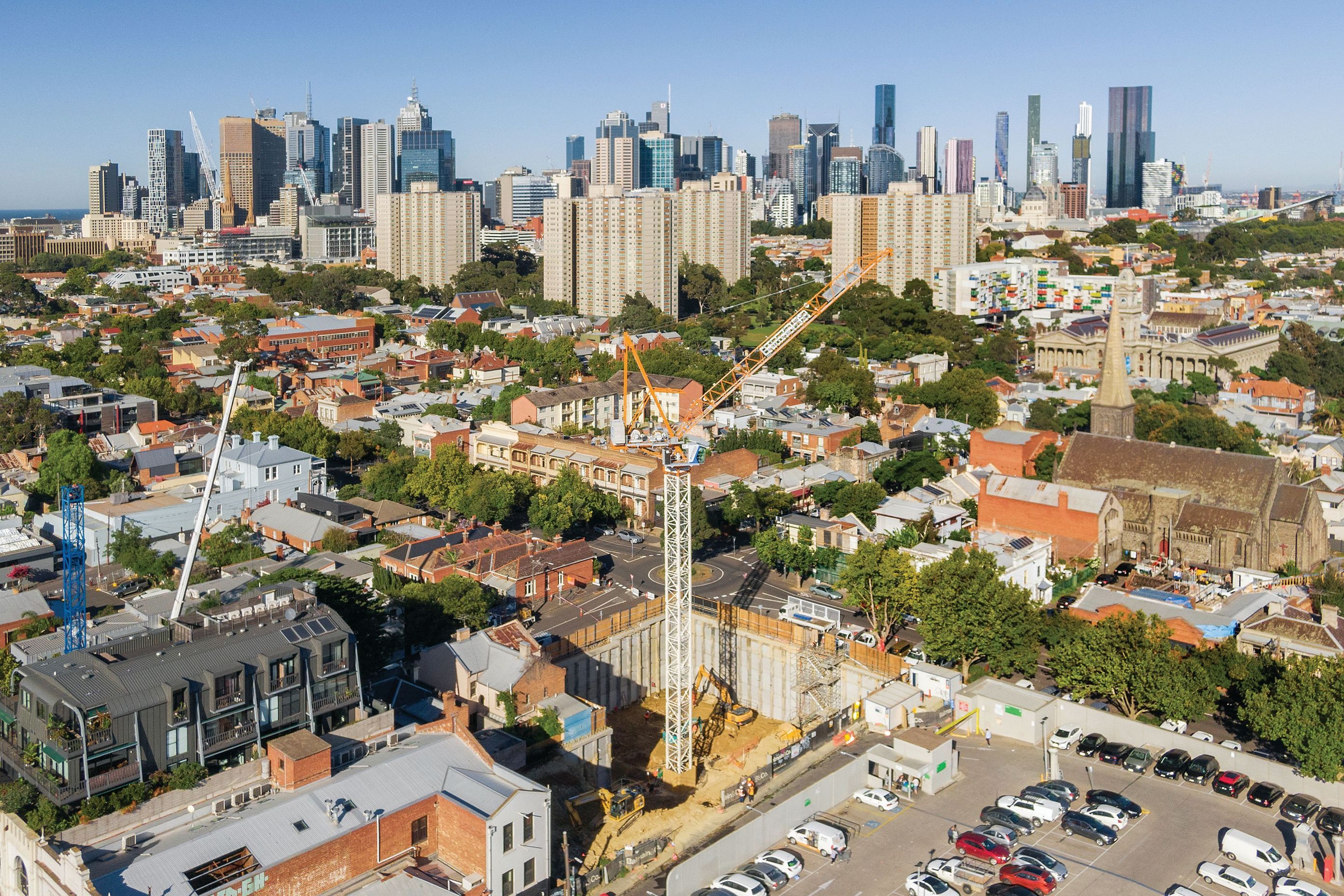

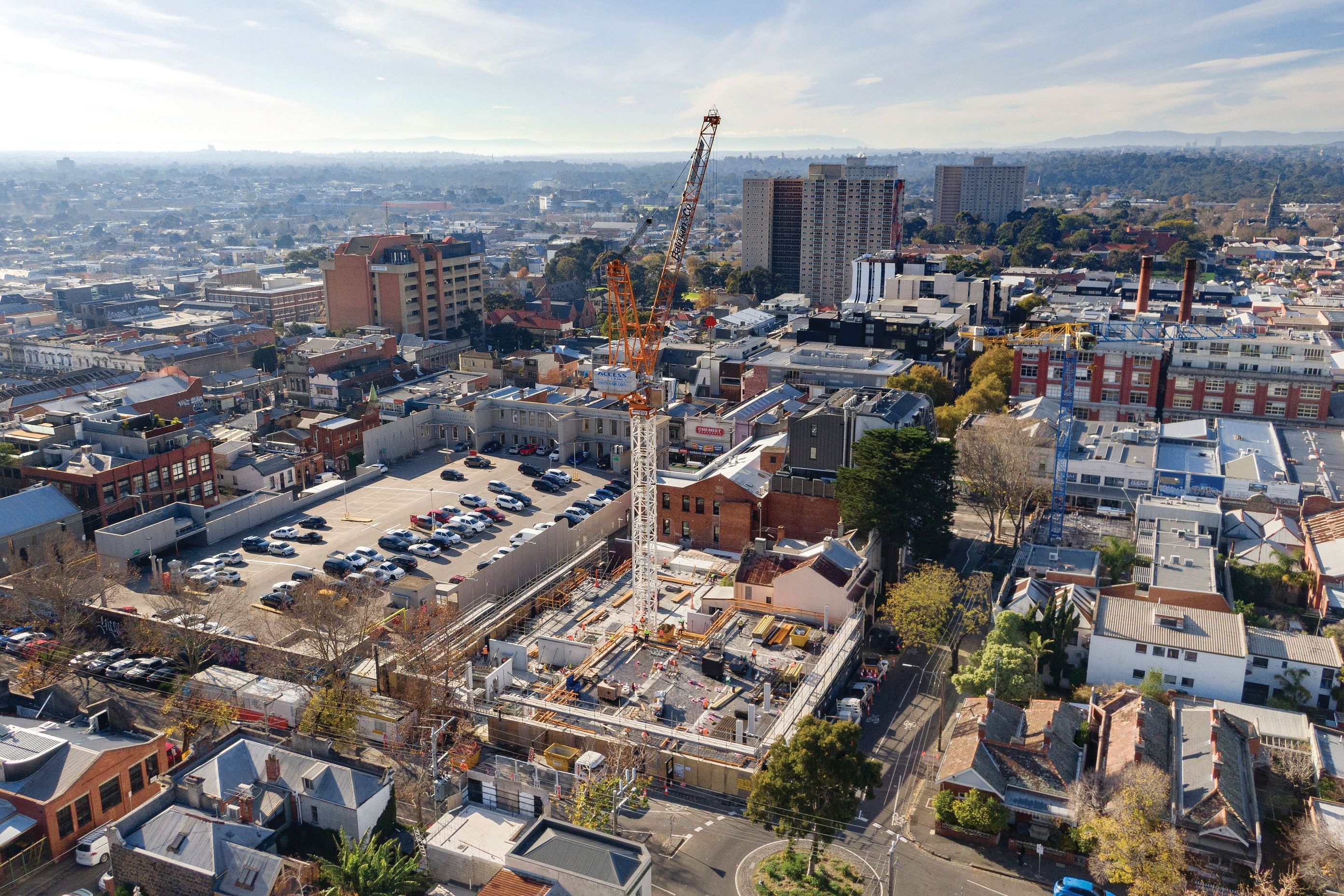

Construction Update: March 2020

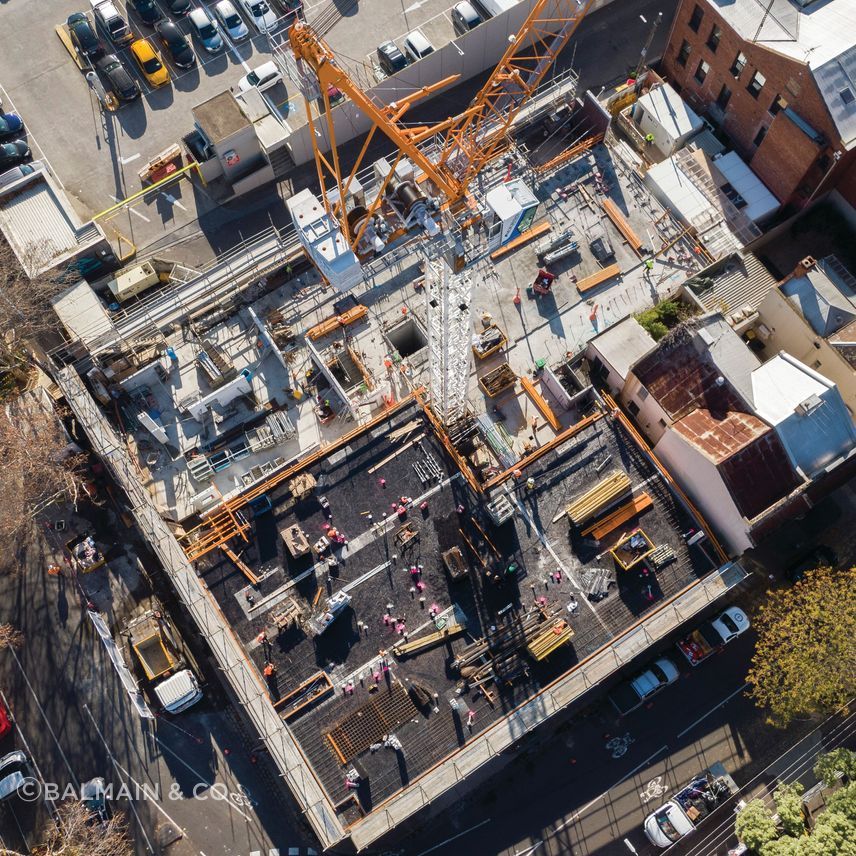

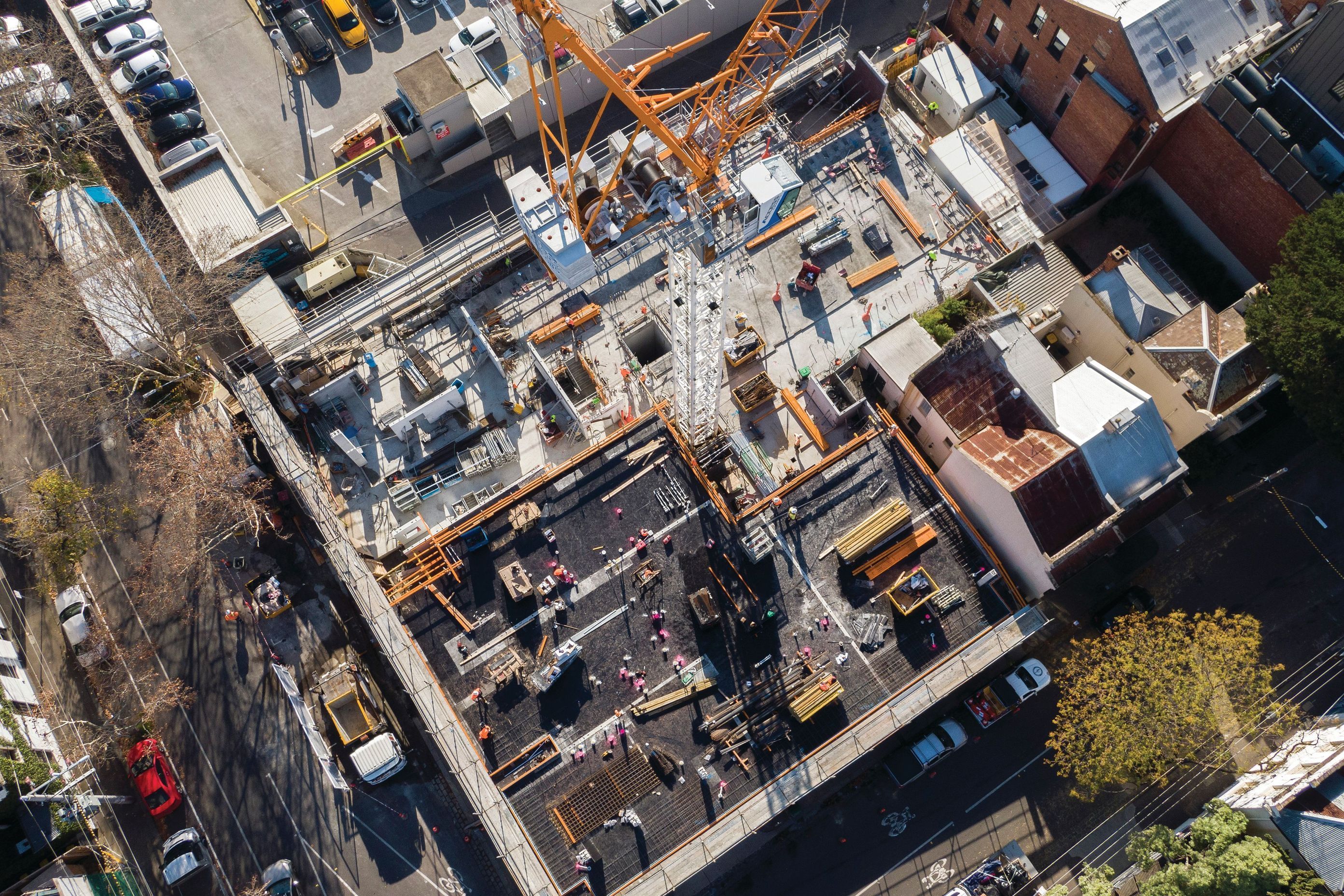

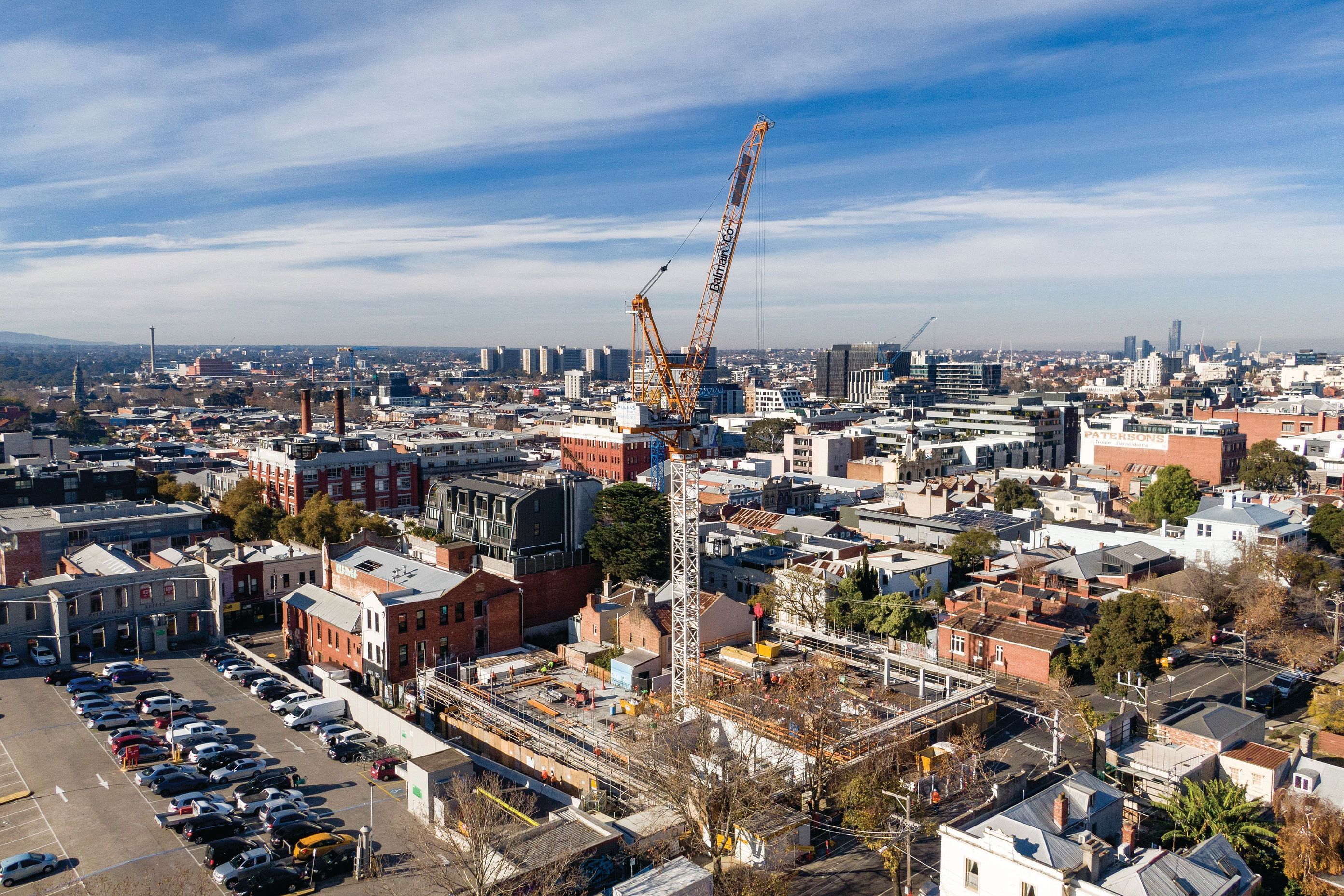

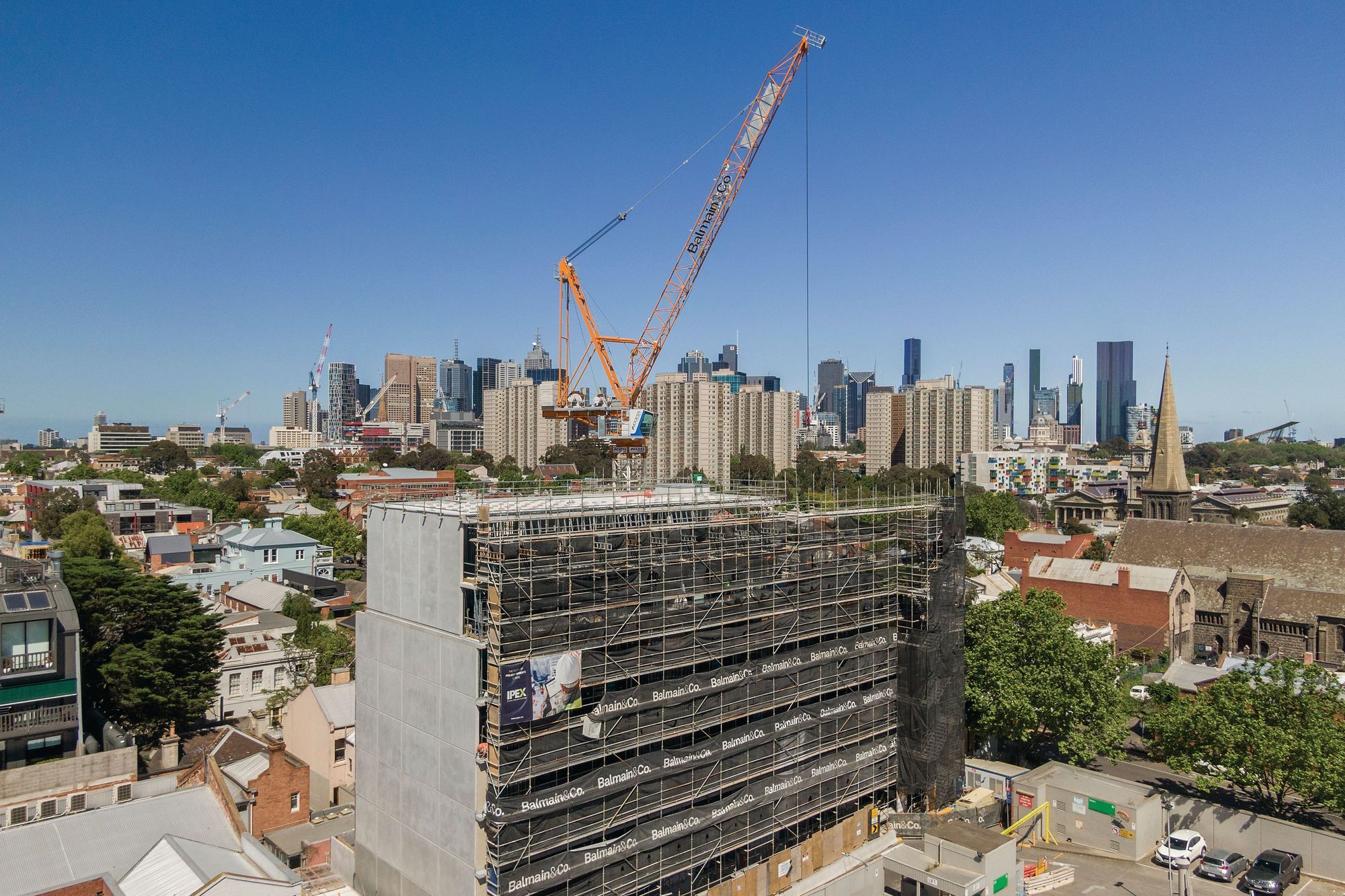

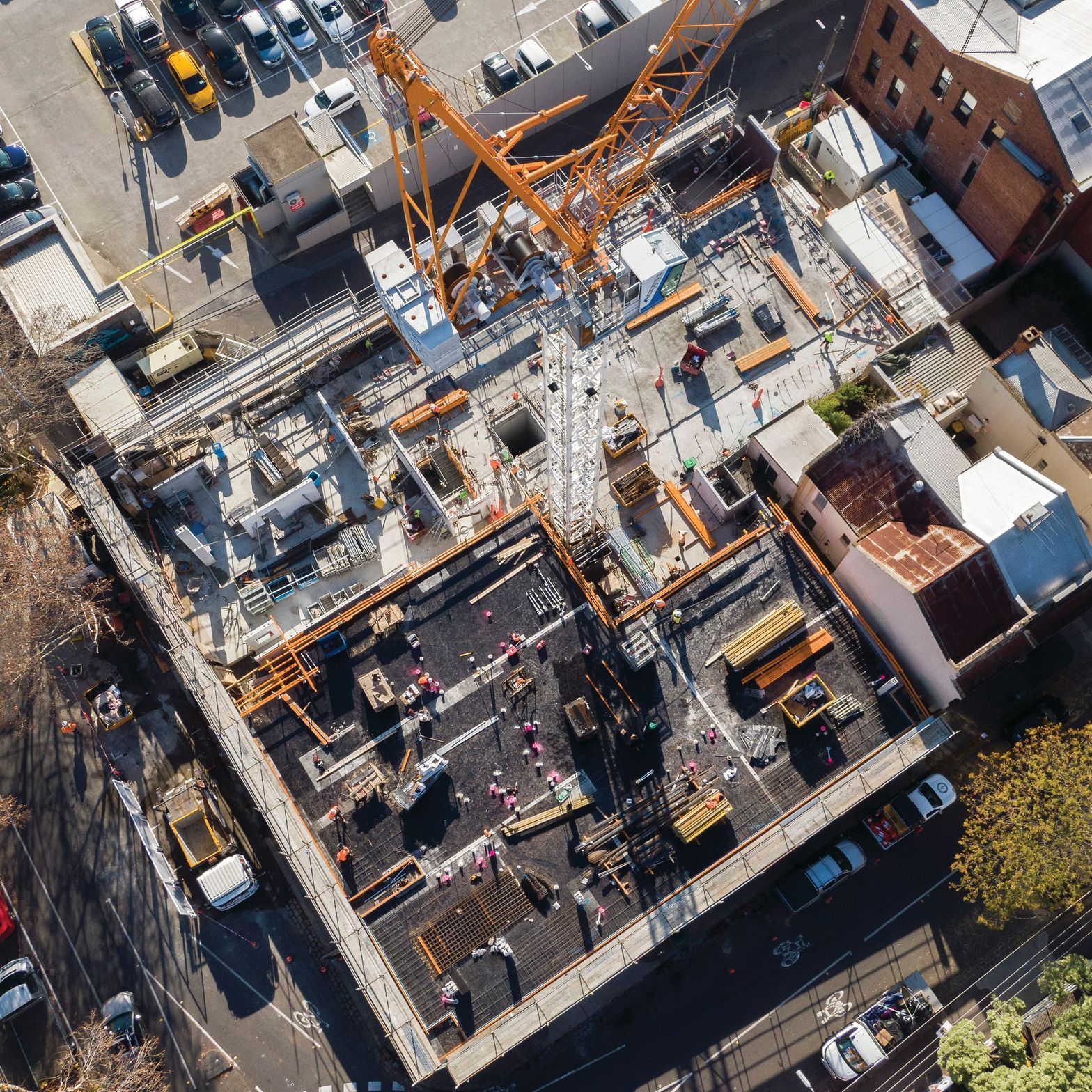

The tower crane at Fitzroy Ltd is up, marking the second Balmain and Co tower crane to grace Fitzroy’s skyline. All footings and in-ground works are complete in the car stacker pit with the slab due to be poured early next week. The final basement retention is on track for completion mid next week, with formwork set to commence on suspended levels shortly after.

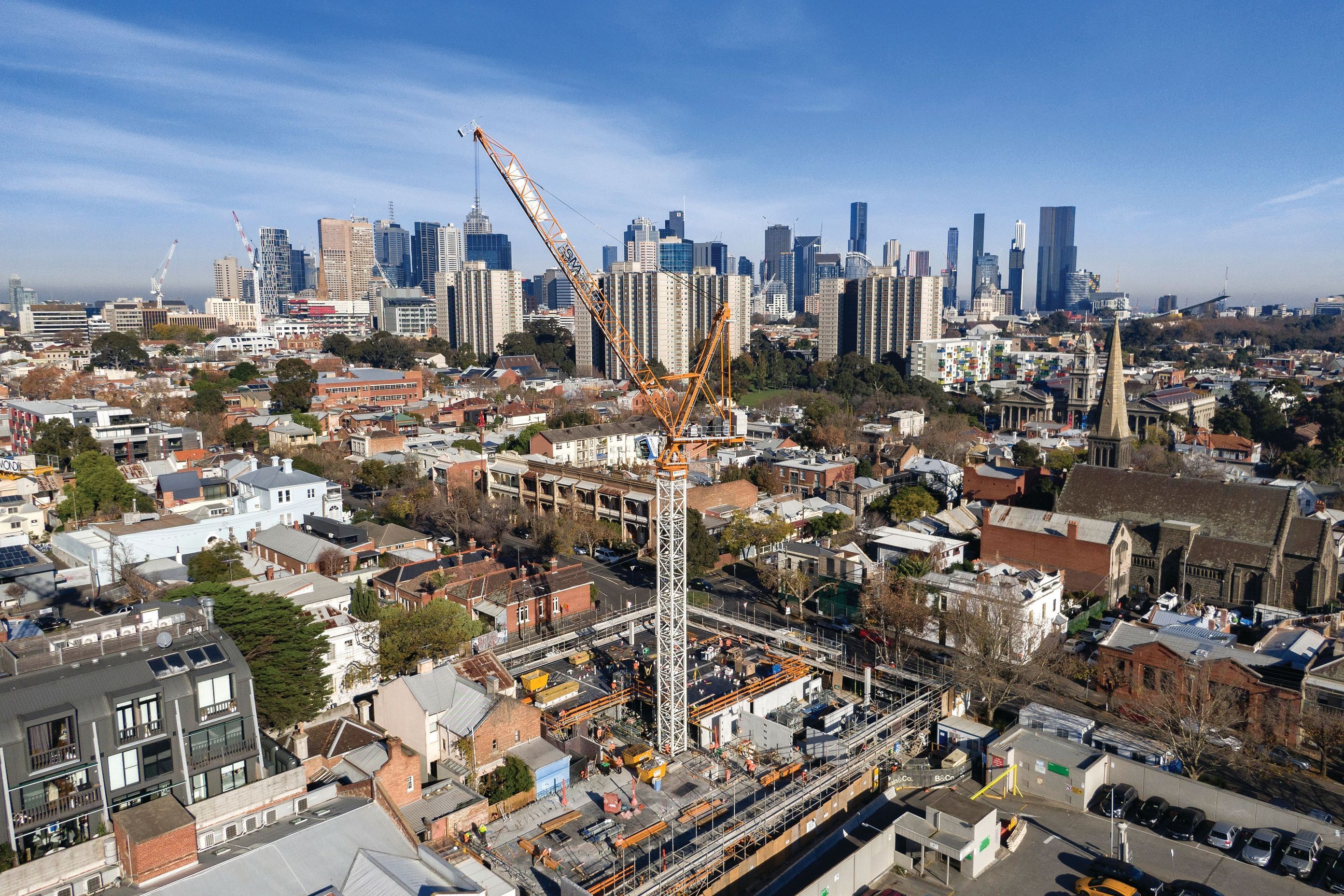

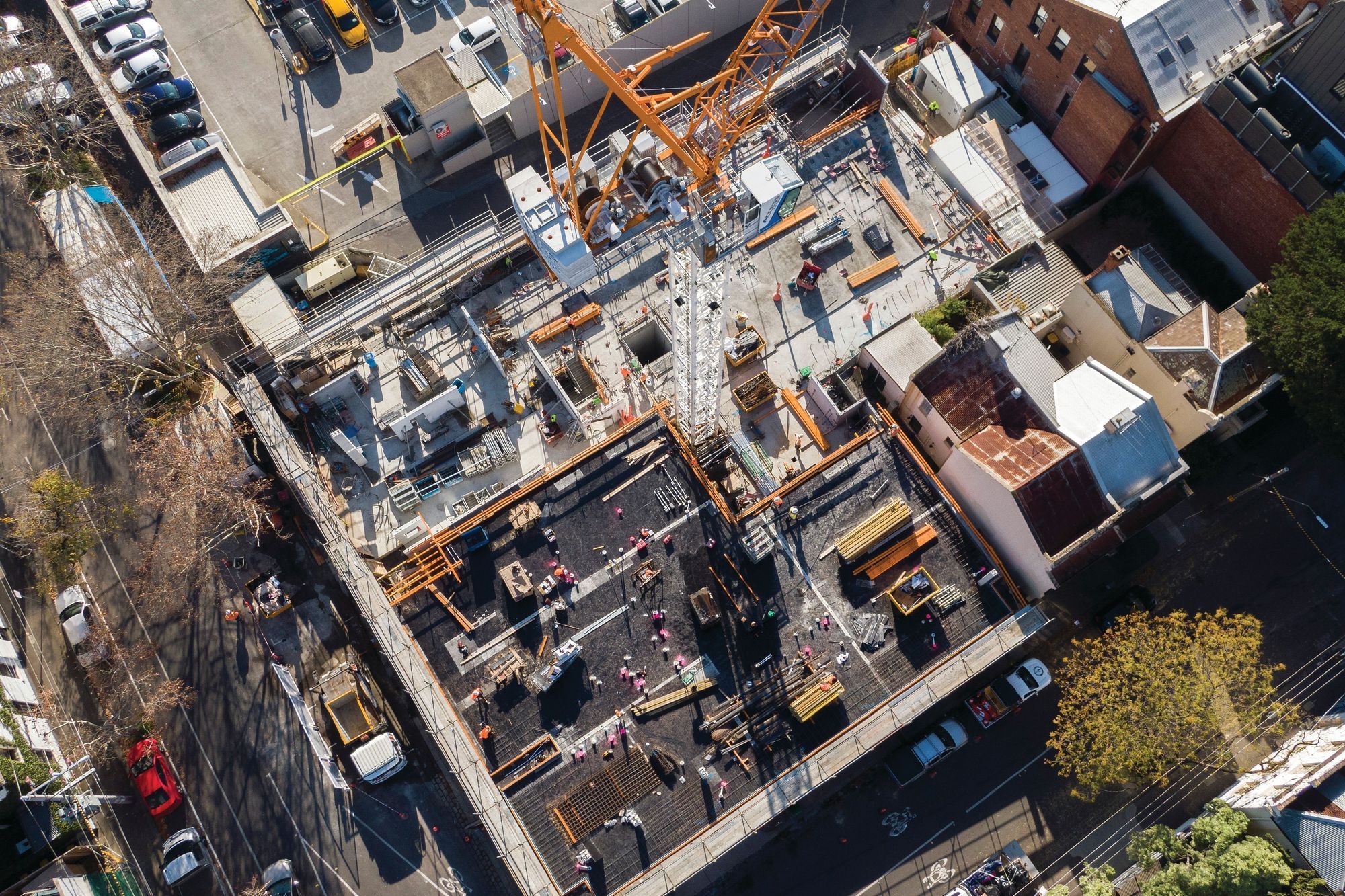

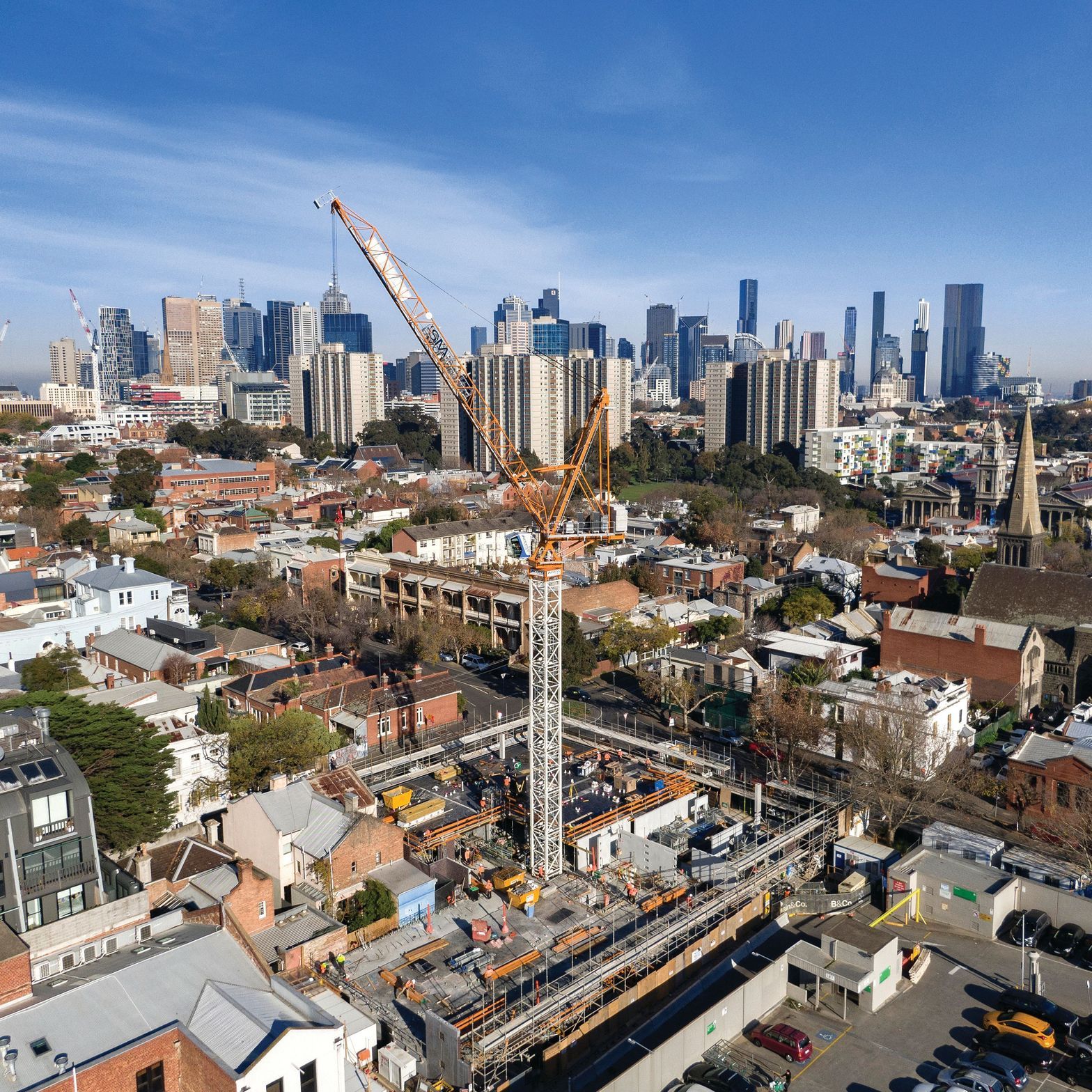

Construction Update: June 2020

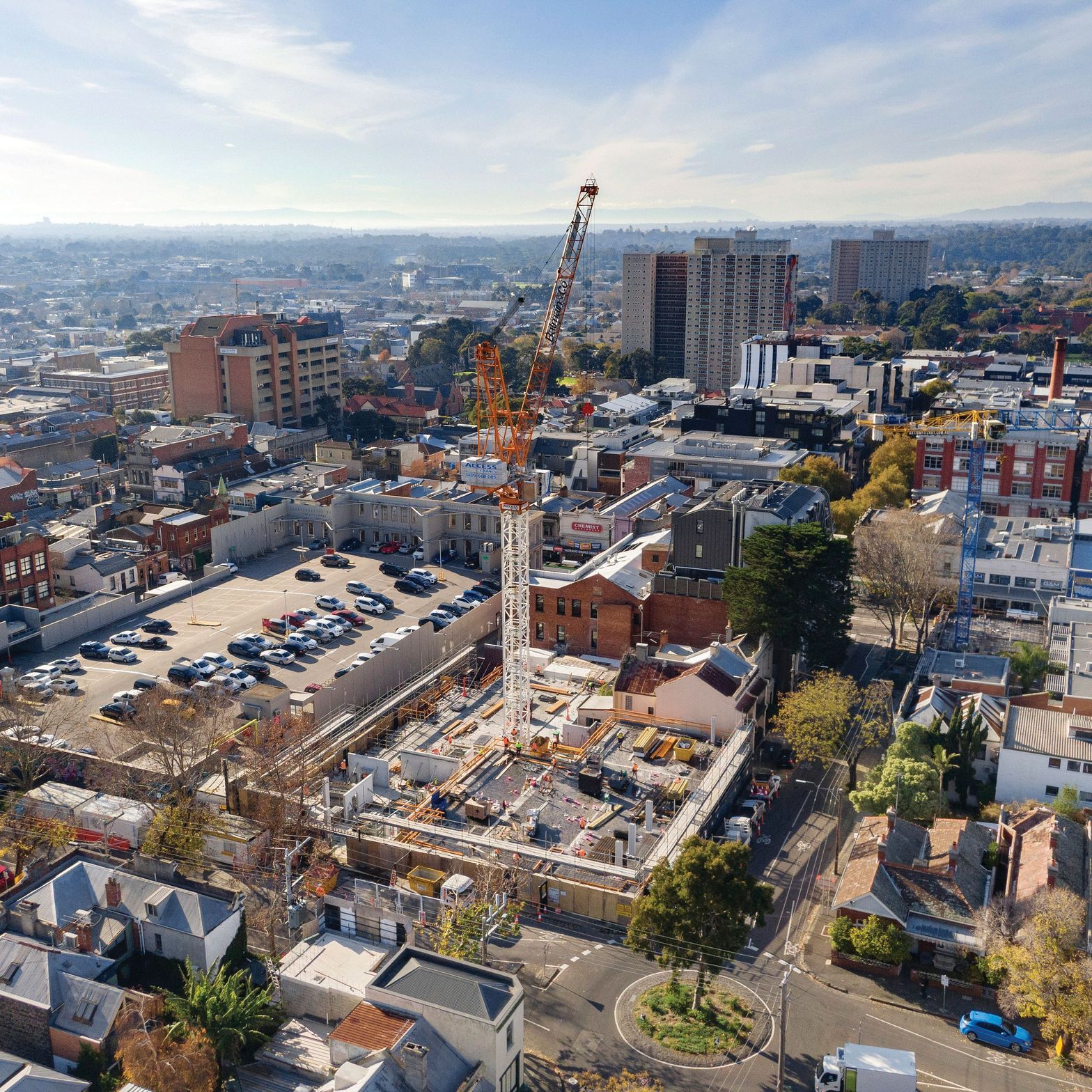

The structure is moving along quickly for Fitzroy Ltd with Level-1 complete and Level-2 due for completion before the month’s close. Basement works have begun with services and car stackers due to commence at the end of June. Formwork stripping for the apartments will take place next month with apartment fit-out to follow.

Construction Update: September 2020

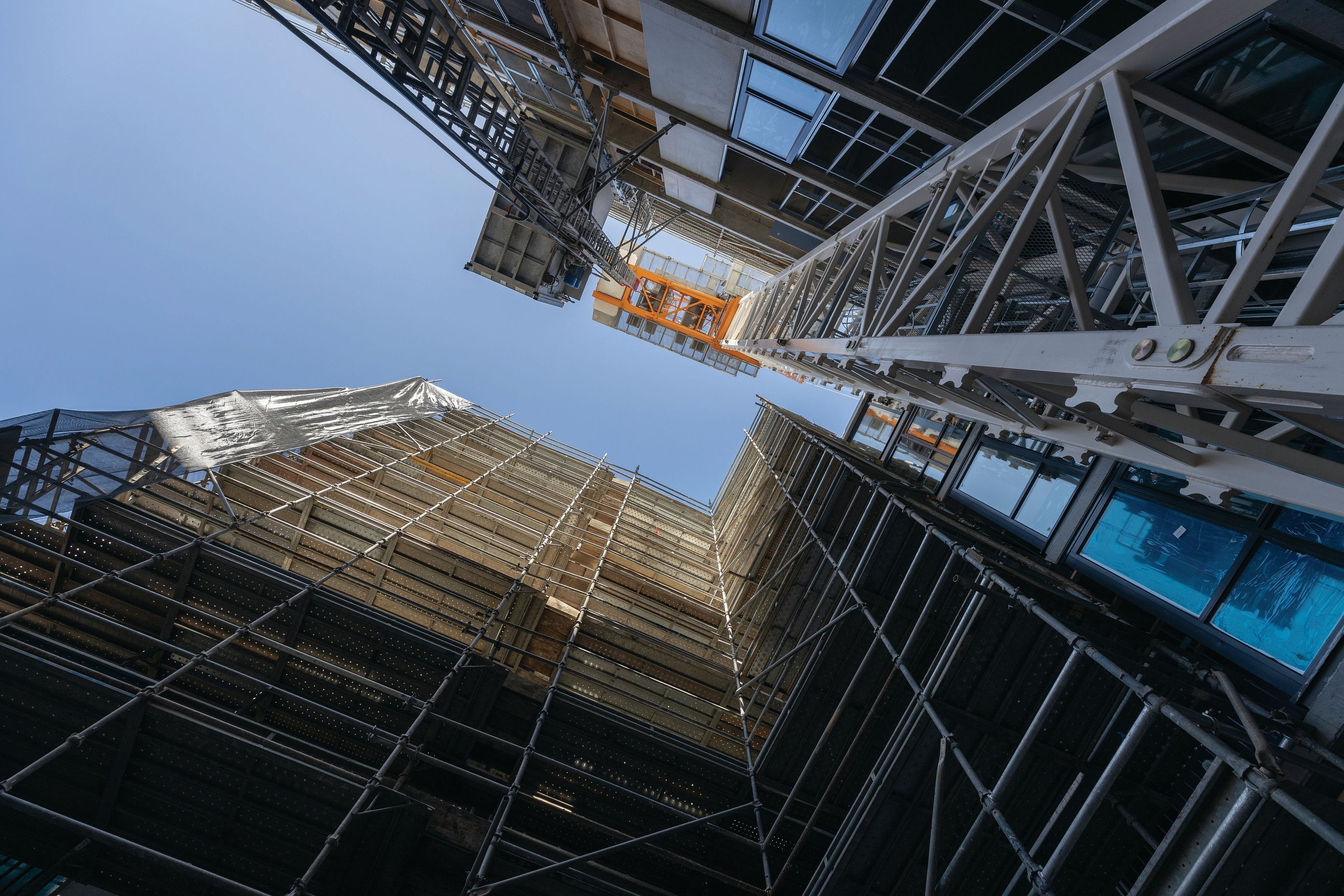

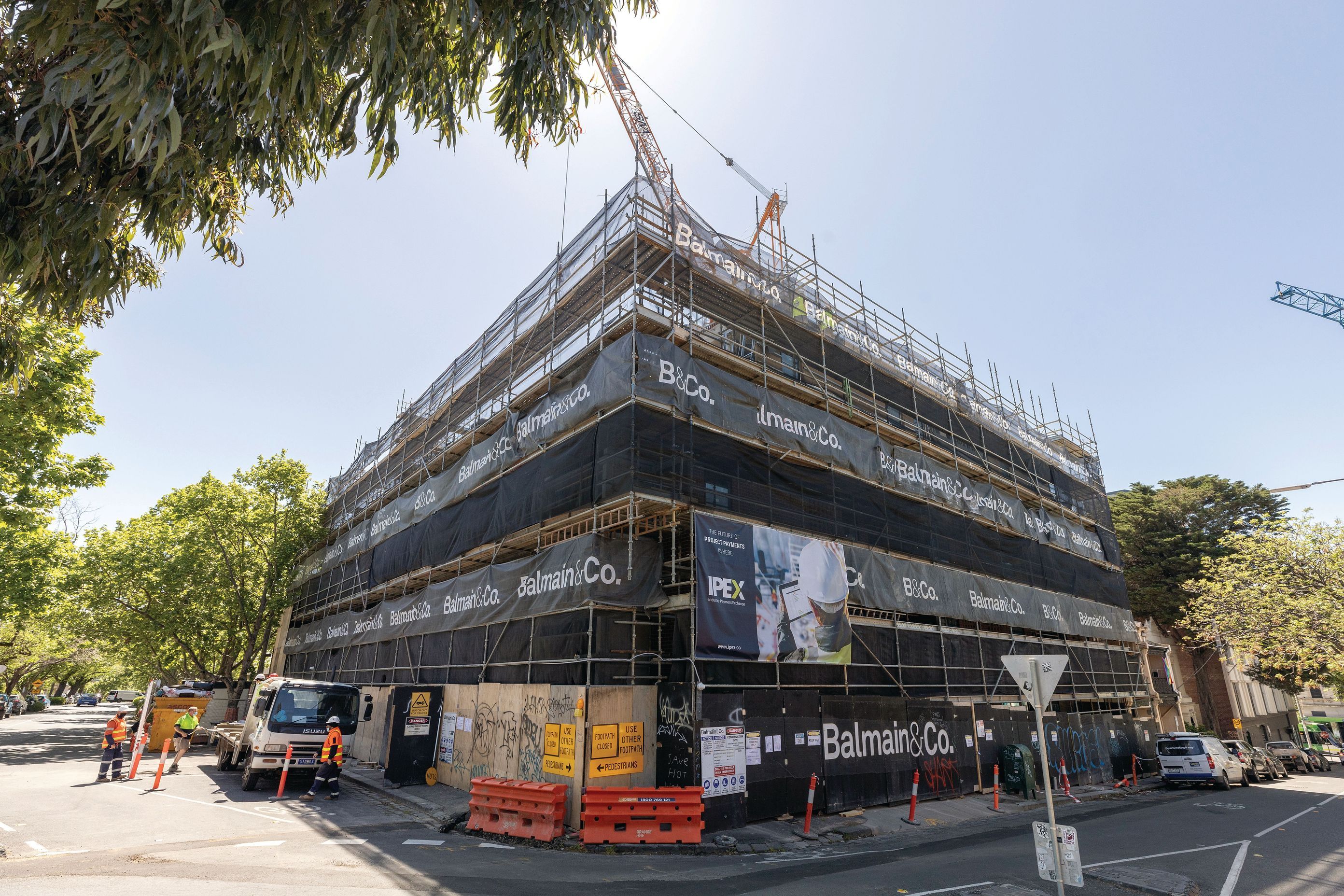

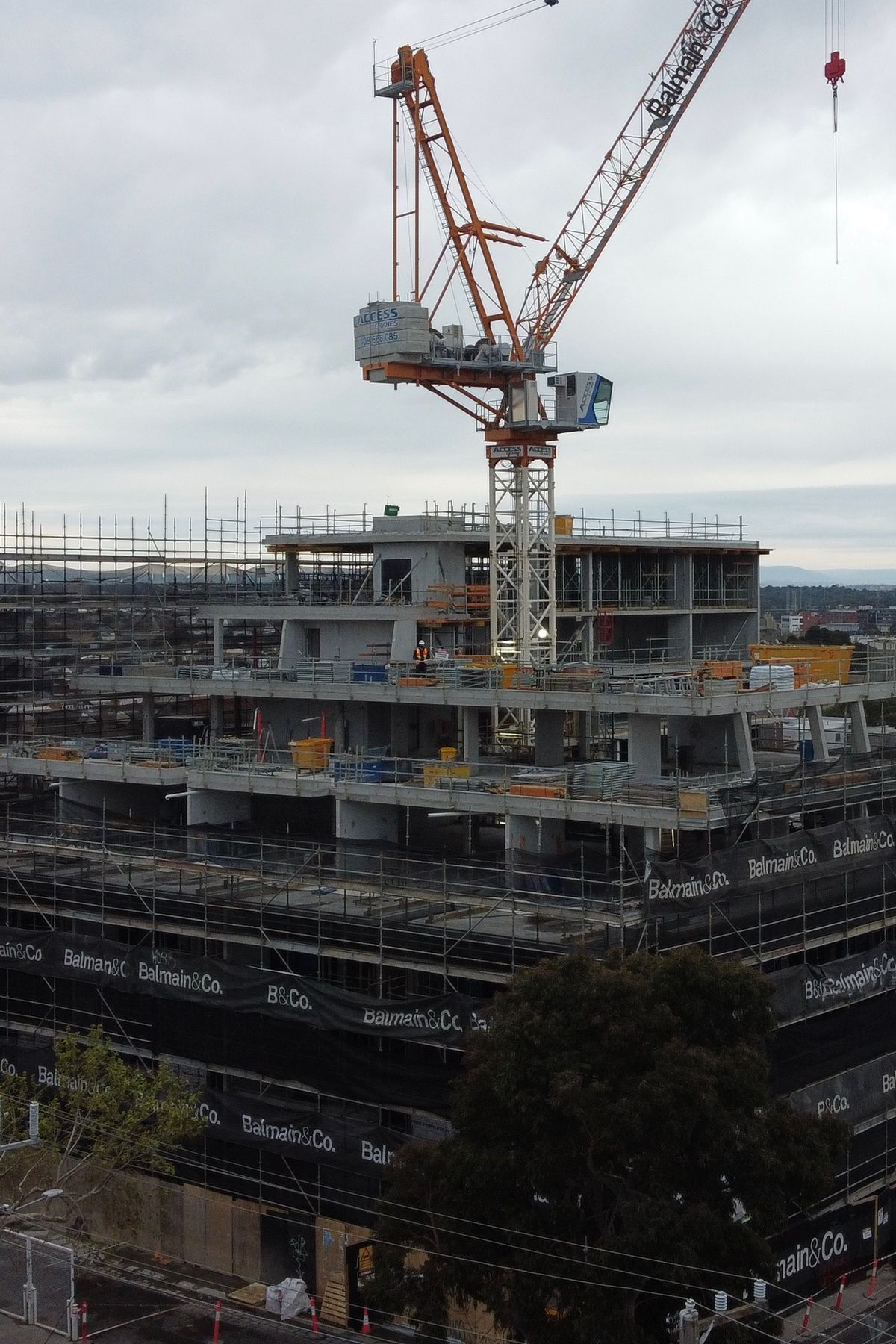

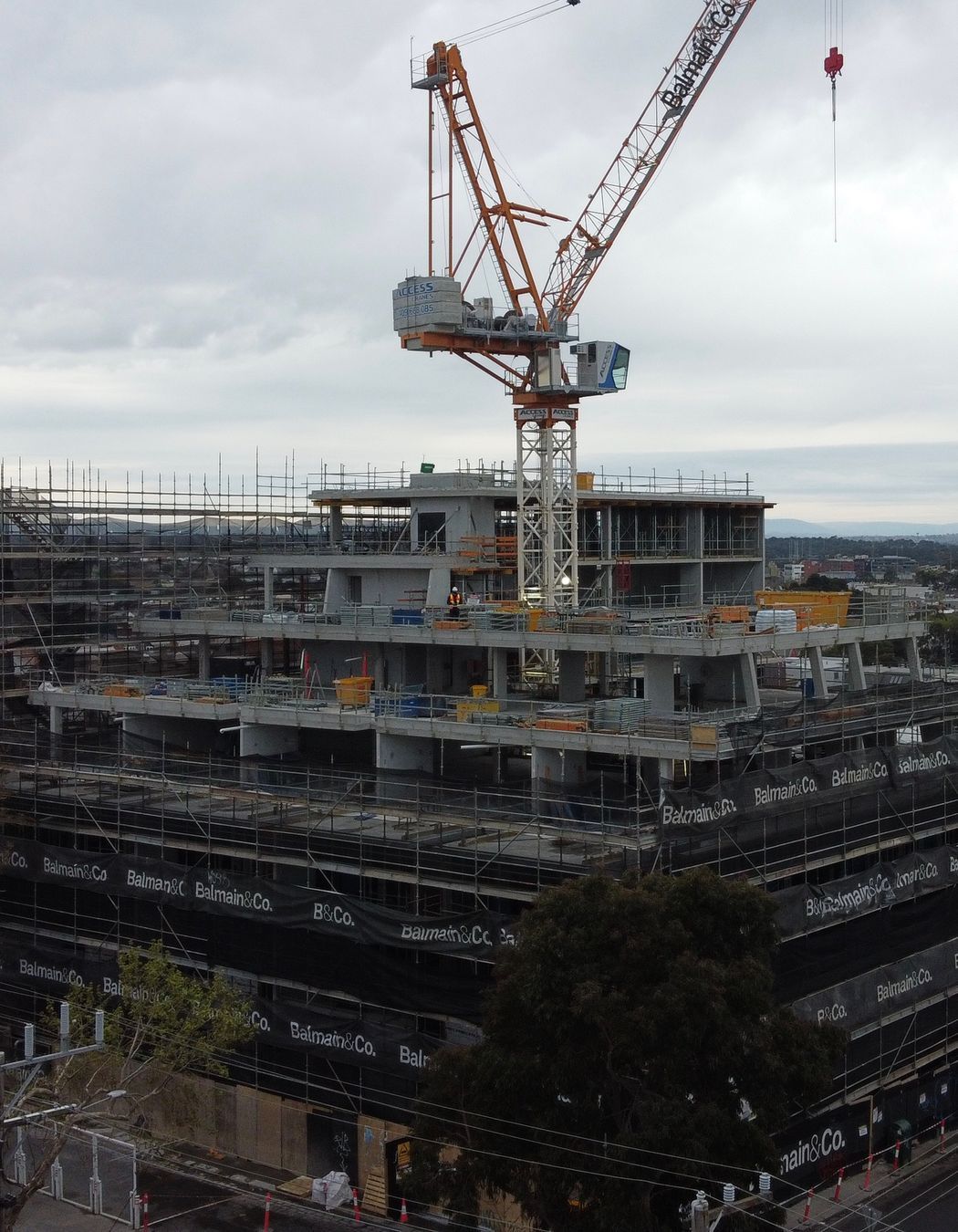

The structure topped out at Fitzroy Ltd with the final roof pour taking place at the end of August. The structure for the car stacker is also nearing completion with the electrical and mechanical stage to commence in the coming weeks. External facade works have now commenced, with the hand-laid brick and metal cladding taking shape. Internally, services and framing is complete up to Level-3 with progress to continue up the building.

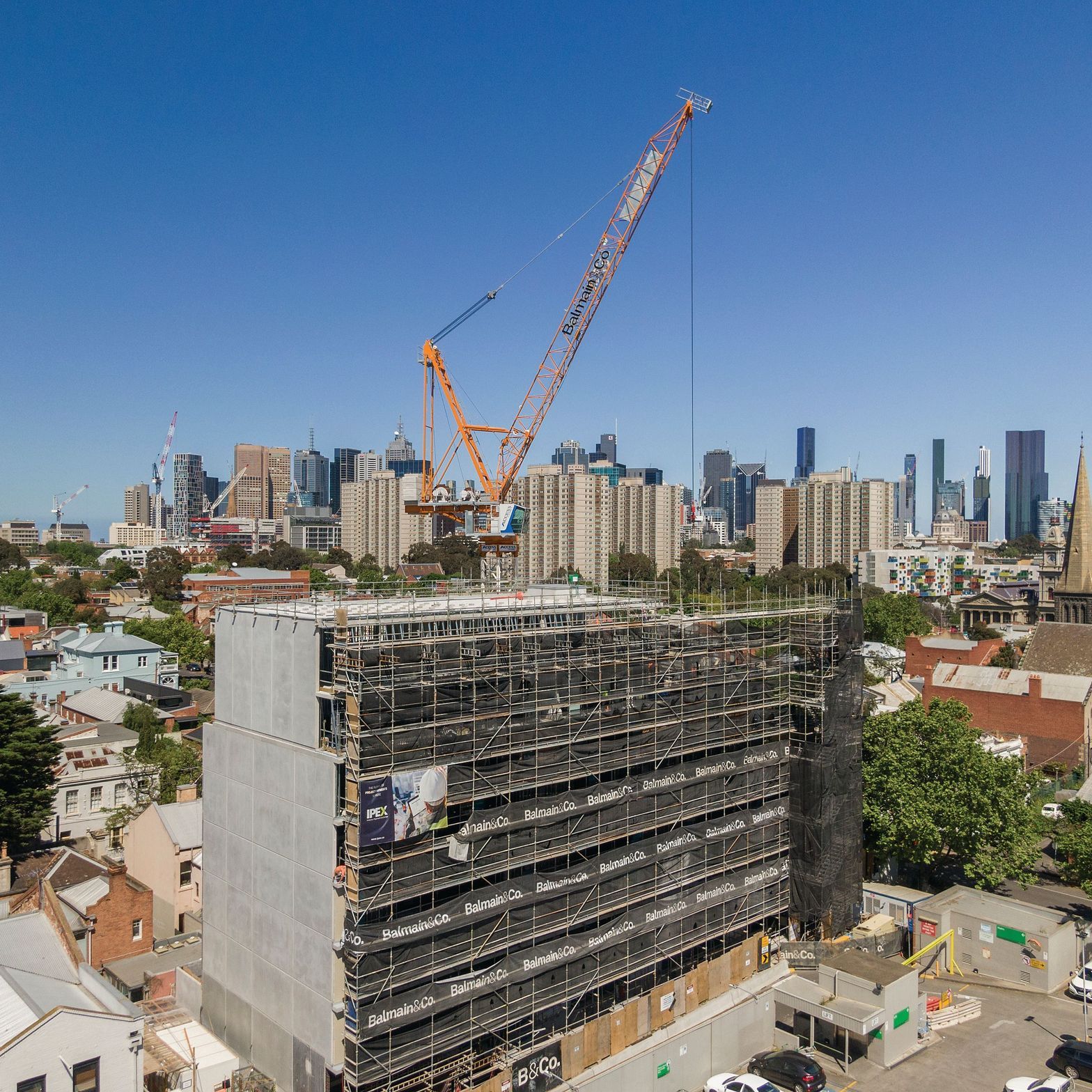

Construction Update: October 2020

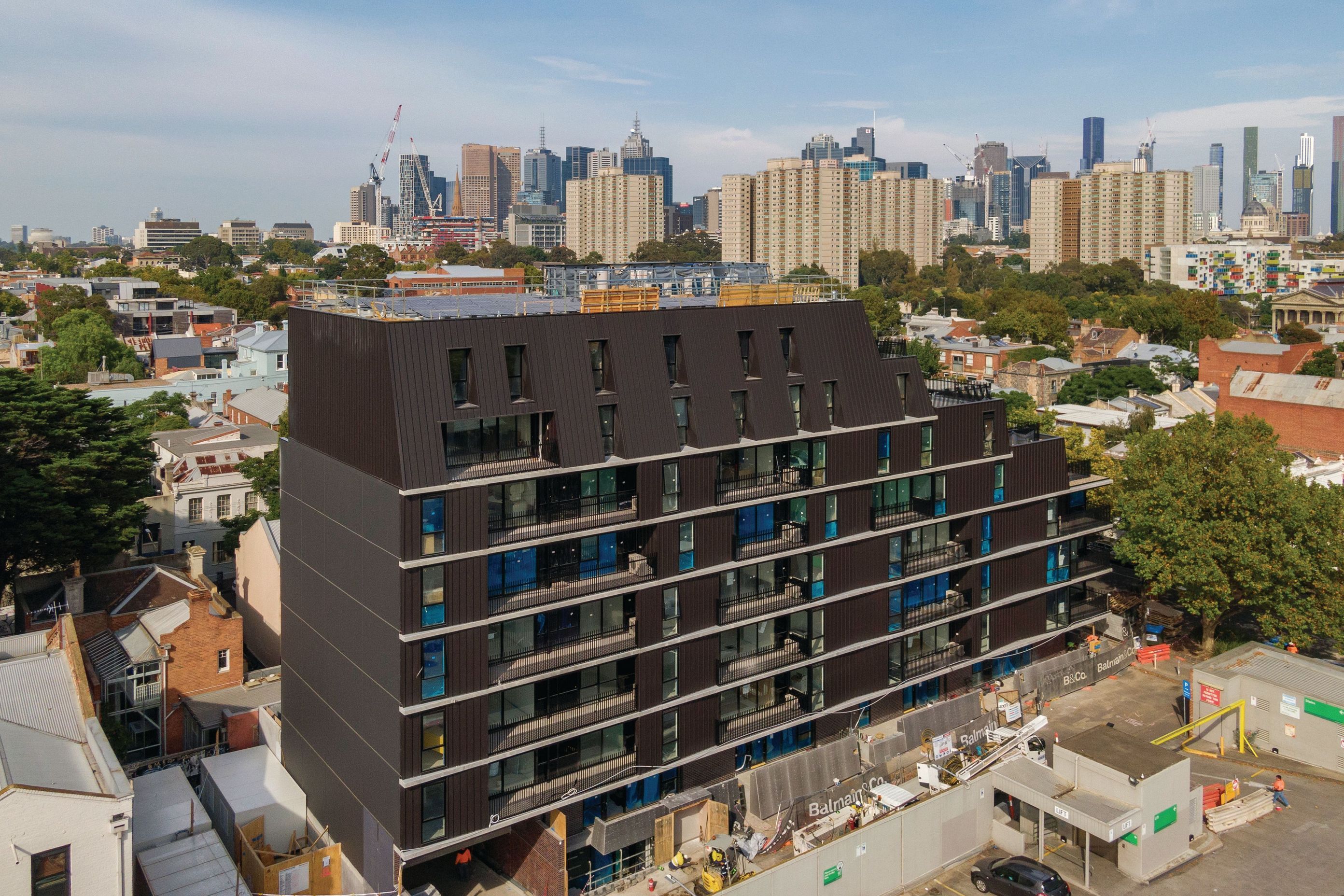

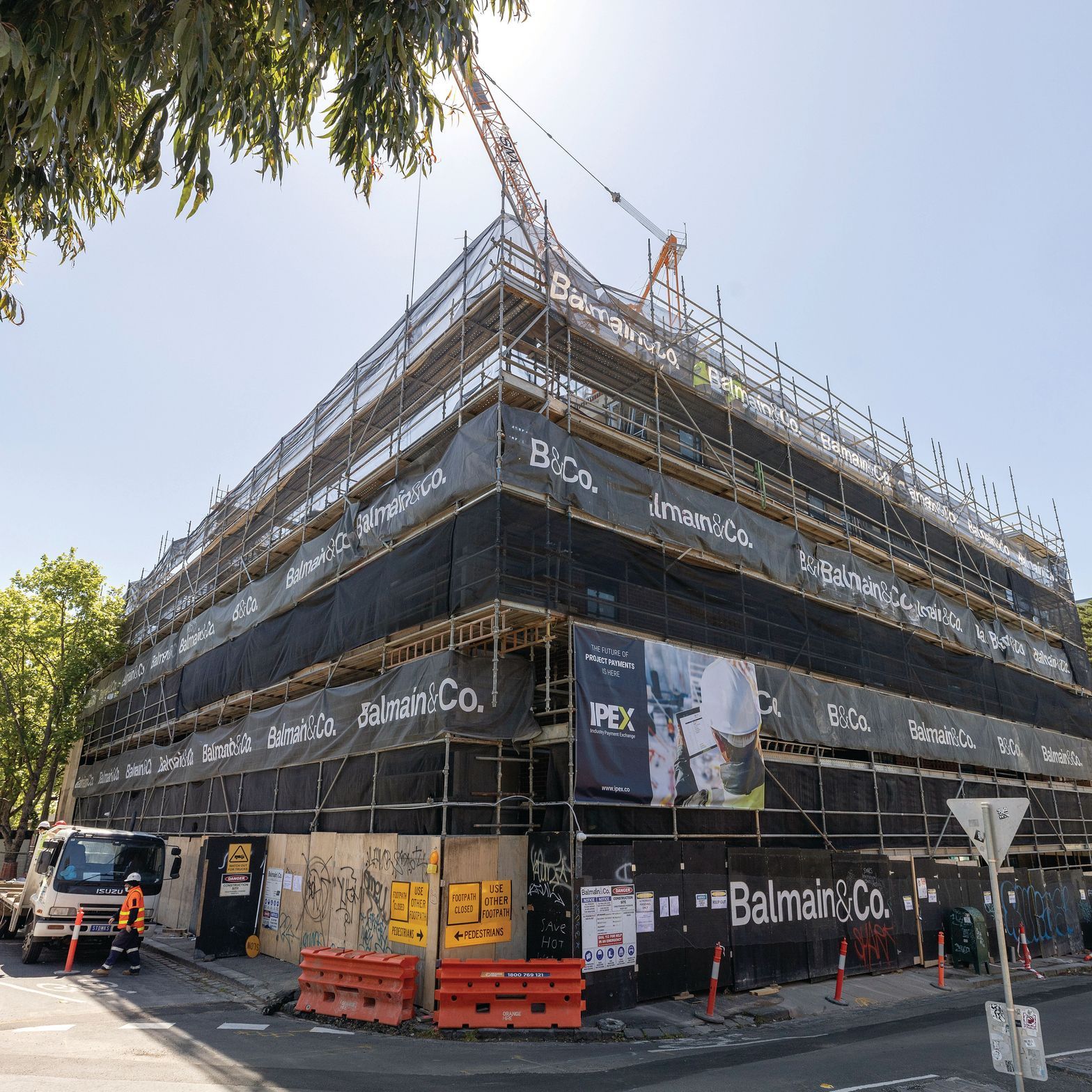

The façade is coming along nicely at Fitzroy Ltd with all brickwork and metal cladding now complete to Level-4. External balustrades are also progressing well with works complete up to Level-7. Internally, plaster and painting has commenced on ground floor and Level-1 with Level-2 through to Level-4 to follow shortly after. In the basement, the structure for the car stacker is now complete with the electrical/ commissioning currently underway.

Construction Update: March 2021

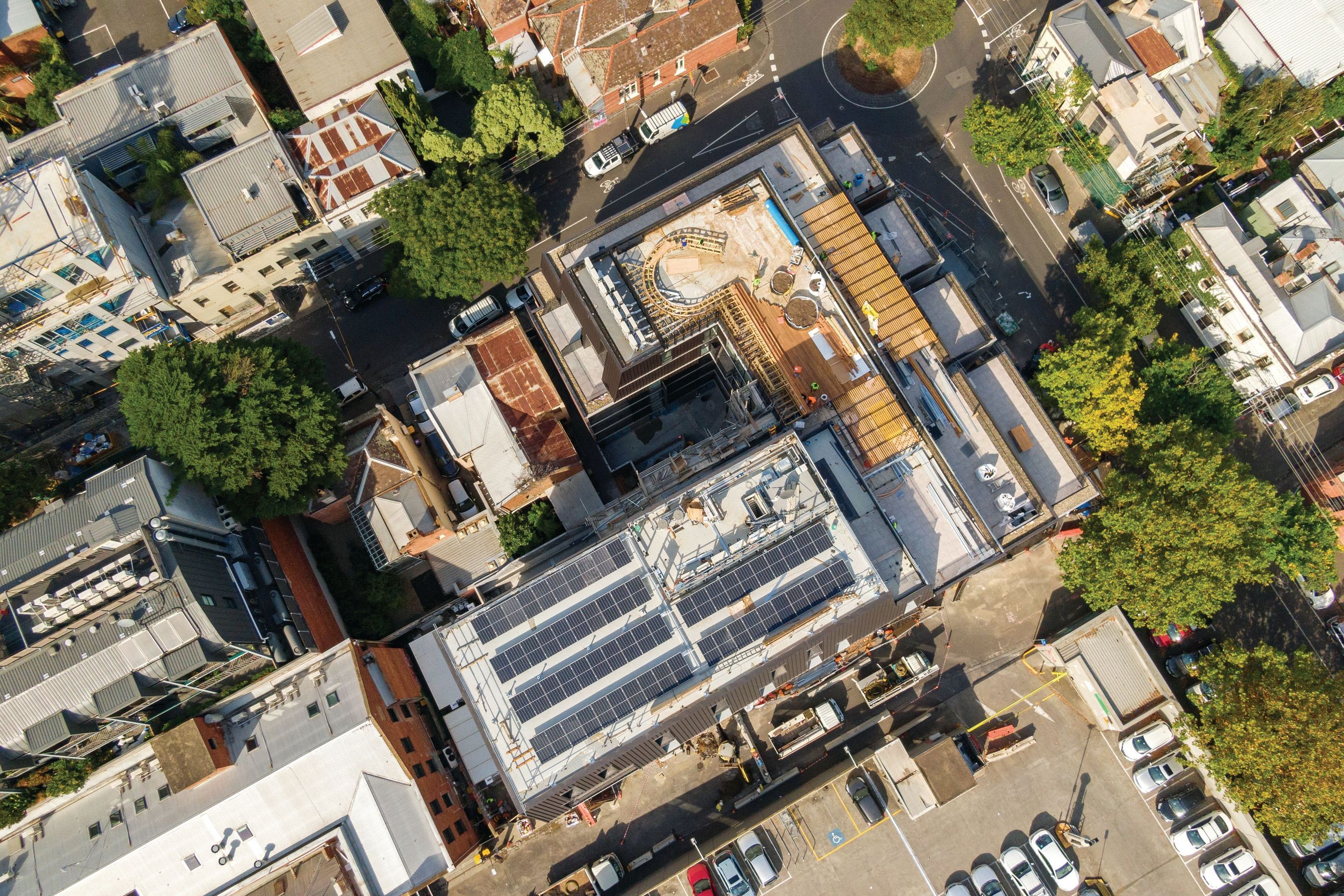

Joinery within the apartments has made great progress on site at Fitzroy Ltd with the apartments nearing completion and penthouses currently in progress. Stone and appliance installation has commenced on the lower levels along with works to the communal areas on the ground floor and level 6. Commissioning of the car stacker is now complete, and on the outside, the façade and external works are also nearing completion.

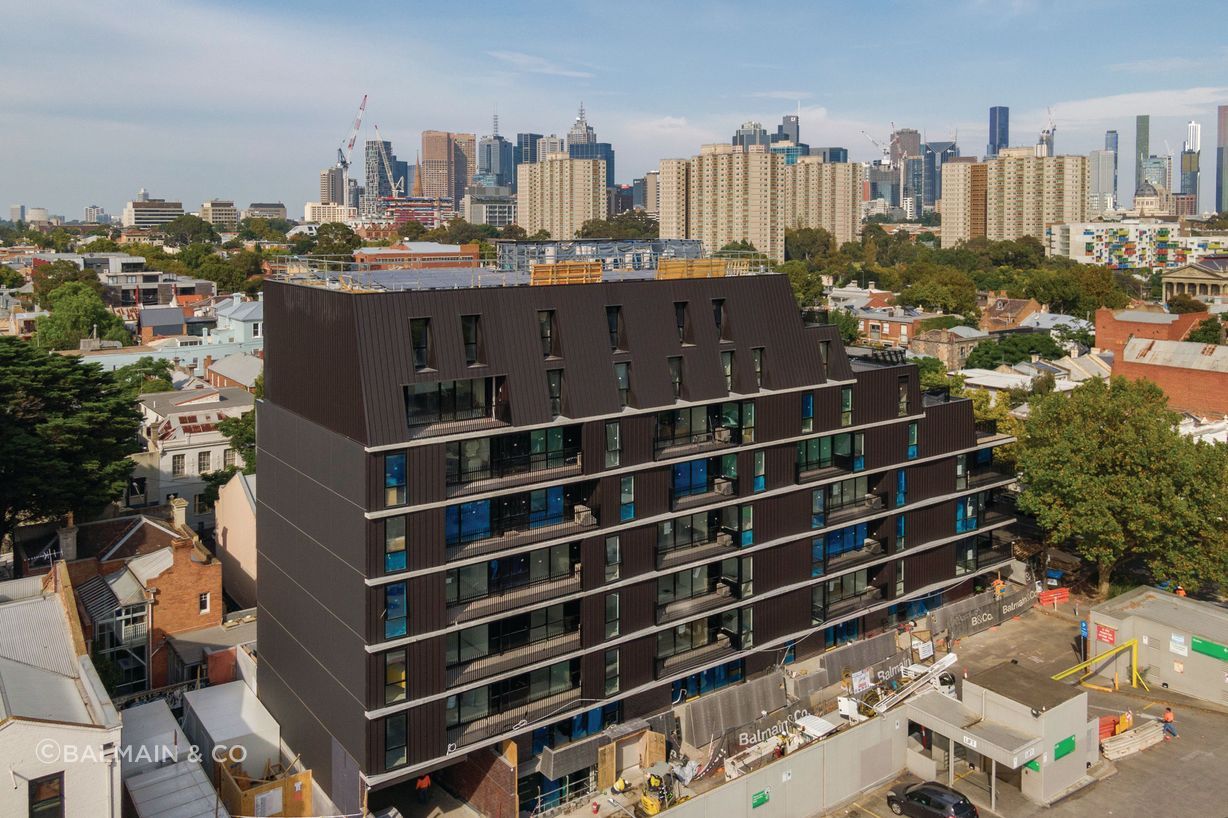

Fitzroy Ltd reached completion in August 2021
